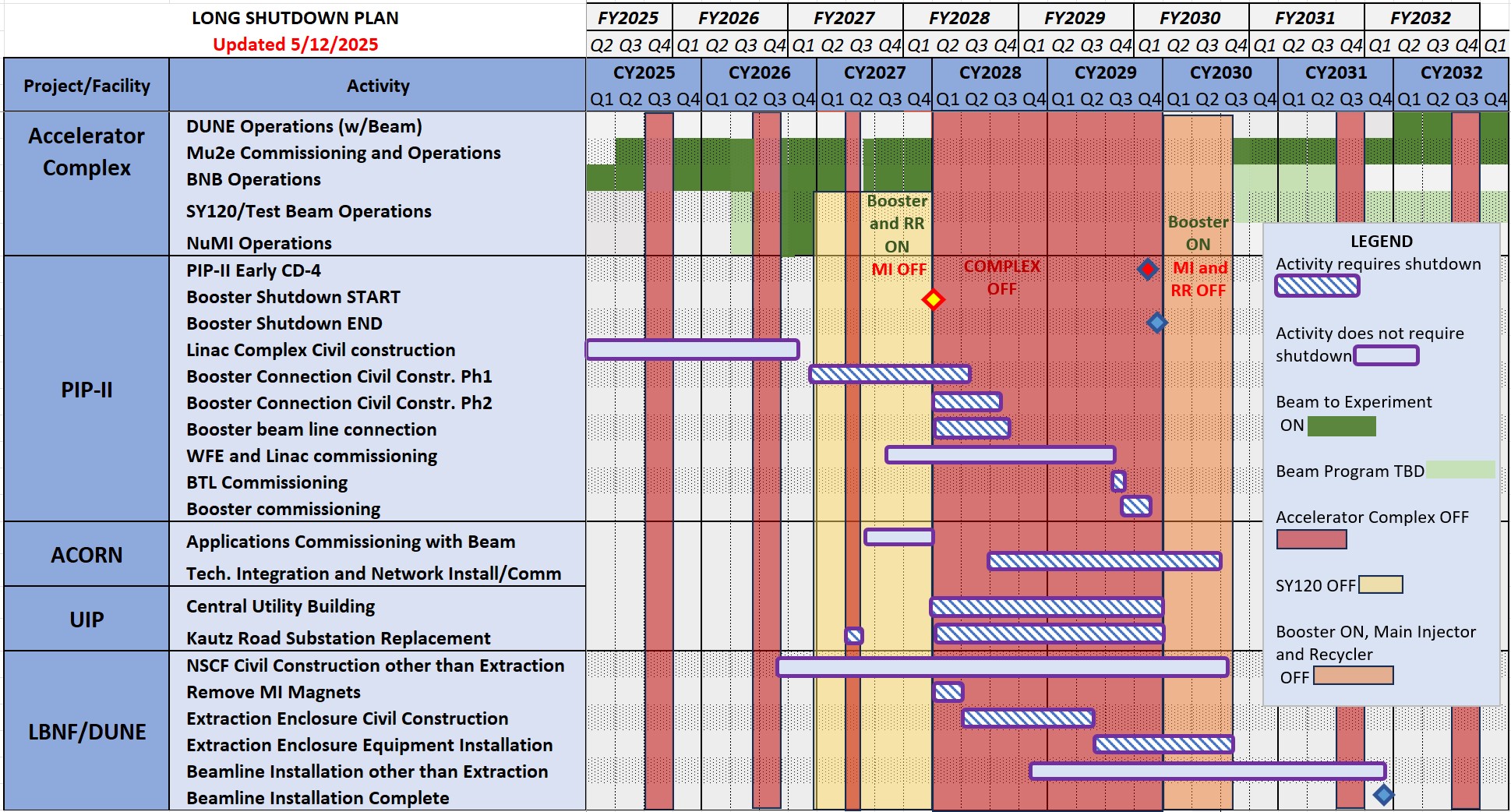

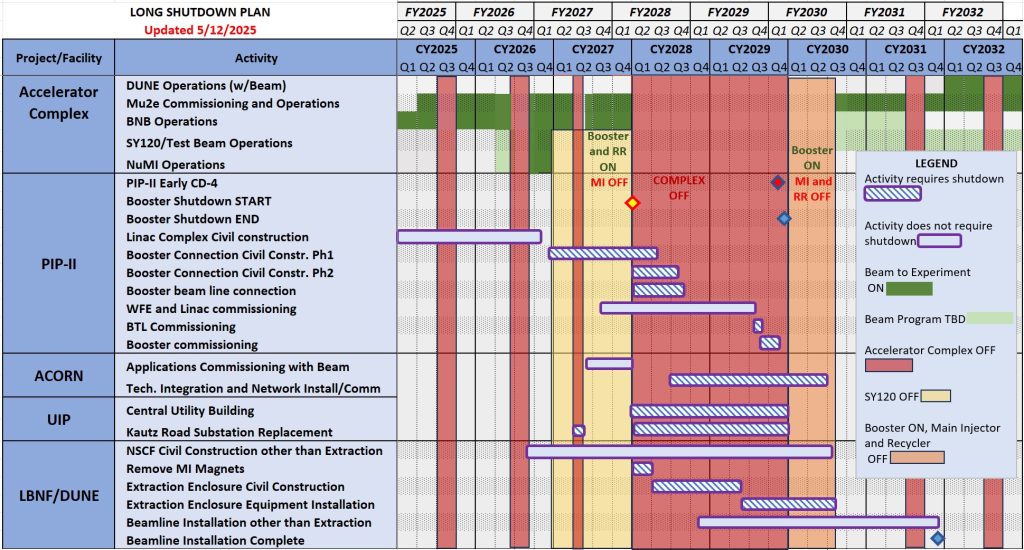

The long-term Accelerator Operations Plan indicates the scheduled beam delivery for the current accelerator complex supporting the ongoing experimental program and the planned integration of PIP-II and the LBNF/DUNE beam with the complex. The plan also includes the timeline for upgrades to the complex and associated infrastructure systems, ACORN and UIP. A major shutdown of the complex (long shutdown) is scheduled for 2028-2029.
Updated May 2025
